Kinder Morgan (KM1 – KM6)

  • Approximately 6.1 miles
  • Pipeline Diameter: 66” to 84” (5.82 miles of 66” diameter to 0.25 mi. of 84” diameter).

KM1

  • Pipeline Diameter: 66″ to 84″
  • 0.9 miles in length

Anticipated Construction Program Schedule

DESIGN

Ends Summer 2020

BID

Winter 2020

CONSTRUCTION

Summer 2021 – Fall 2022

Design Consultant: Halff Associates

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM1

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change

SWSP - Kinder Morgan - KM1

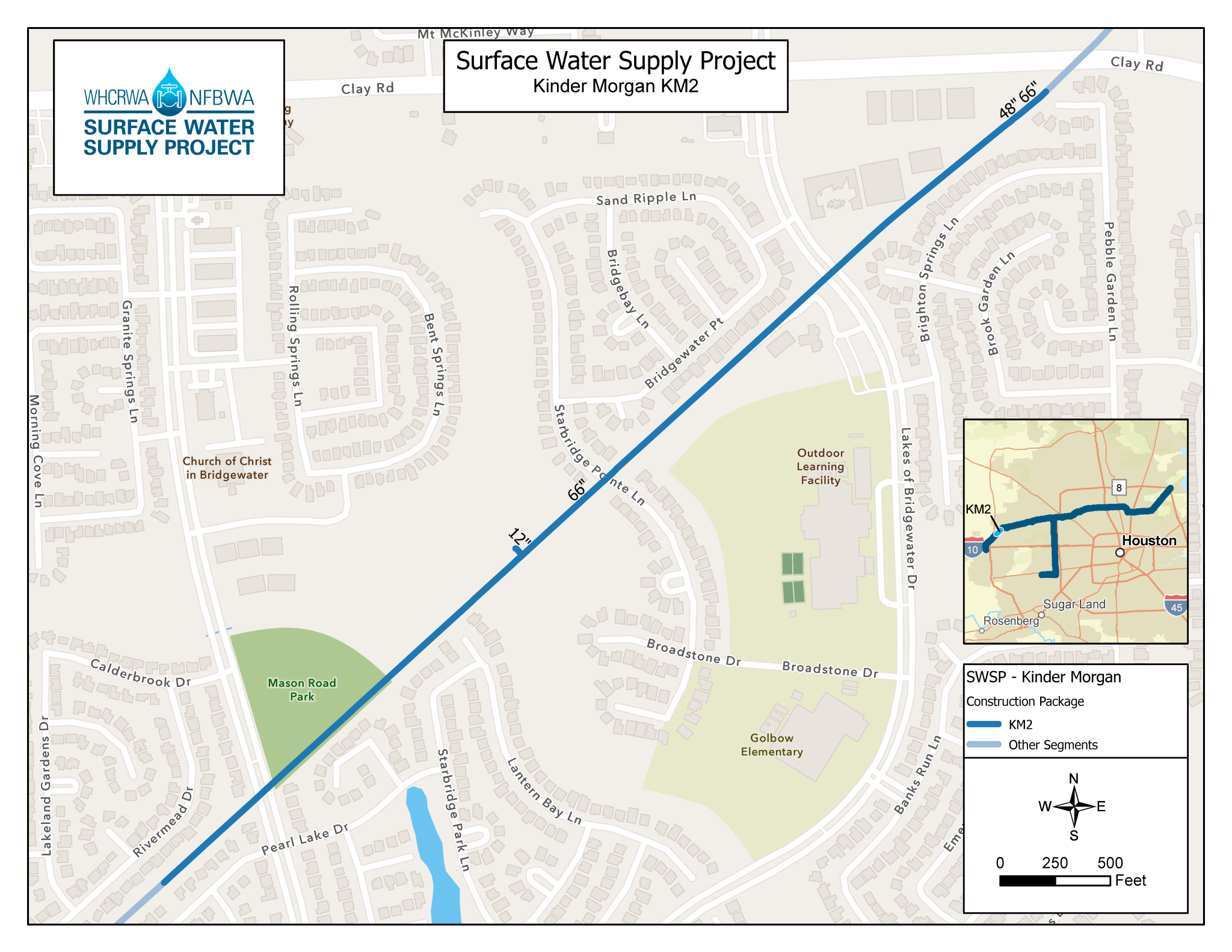

KM2

  • Pipeline Diameter: 66″ to 84″
  • 1 mile in length

Anticipated Construction Program Schedule

DESIGN

Ends Summer 2020

BID

Winter 2020

CONSTRUCTION

Summer 2021 – Late Summer 2022

Design Consultant: IDS Engineering

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM2

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change

SWSP - Kinder Morgan - KM2

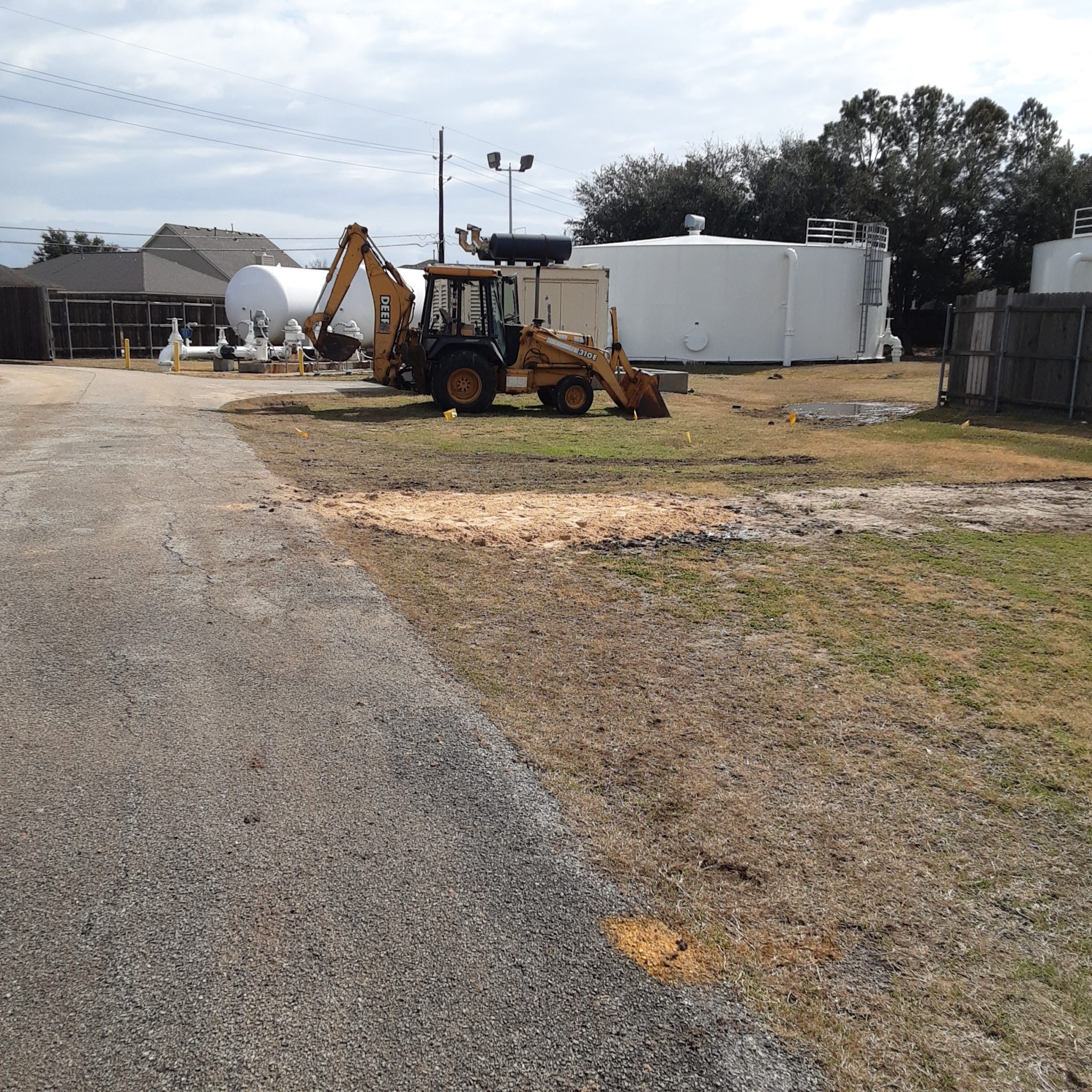

KM3

  • Pipeline Diameter: 66″ to 84″
  • 1 mile in length

Anticipated Construction Program Schedule

DESIGN

Ends Summer 2020

BID

Fall 2020

CONSTRUCTION

Spring 2021 – Summer 2022

Design Consultant: Garver

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM3

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change

SWSP - Kinder Morgan - KM3

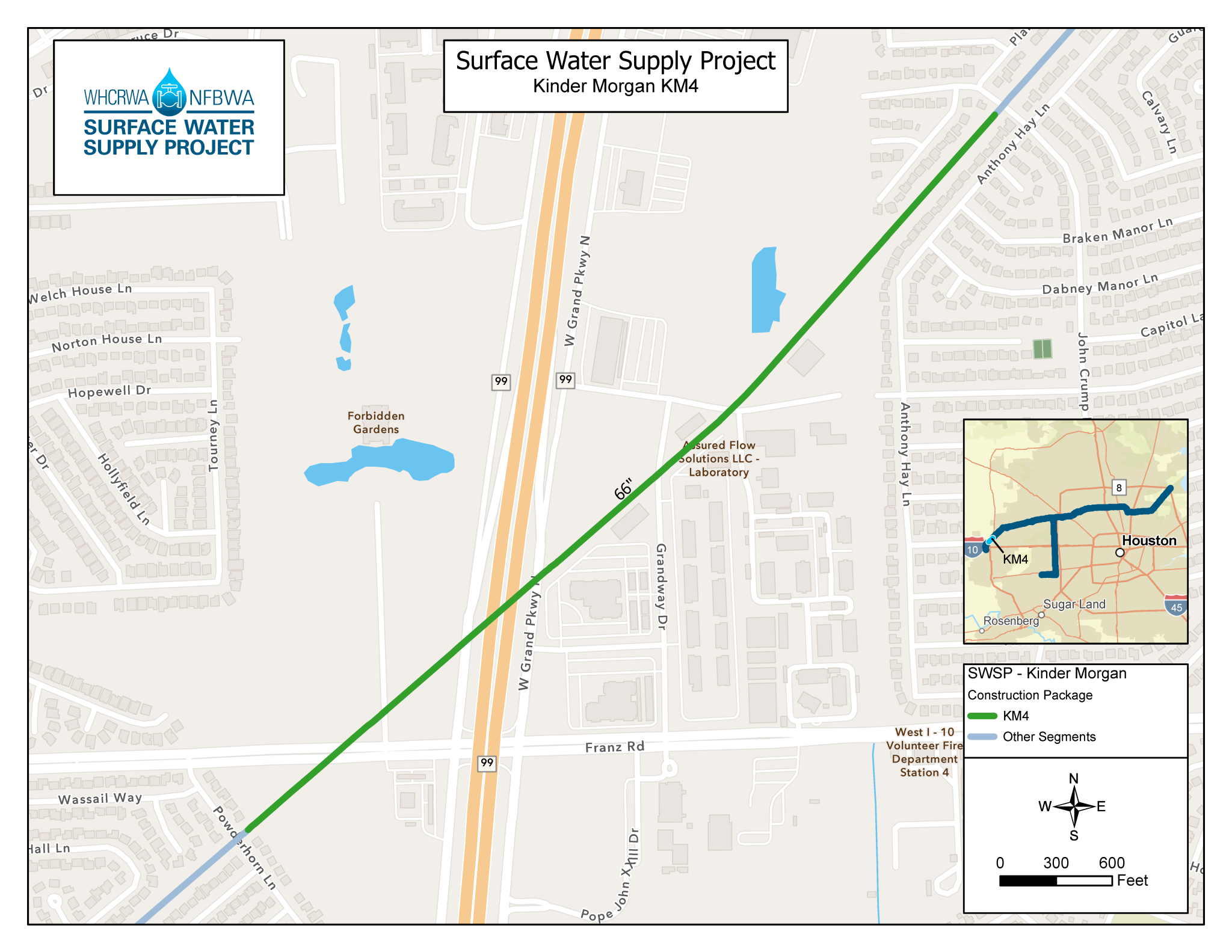

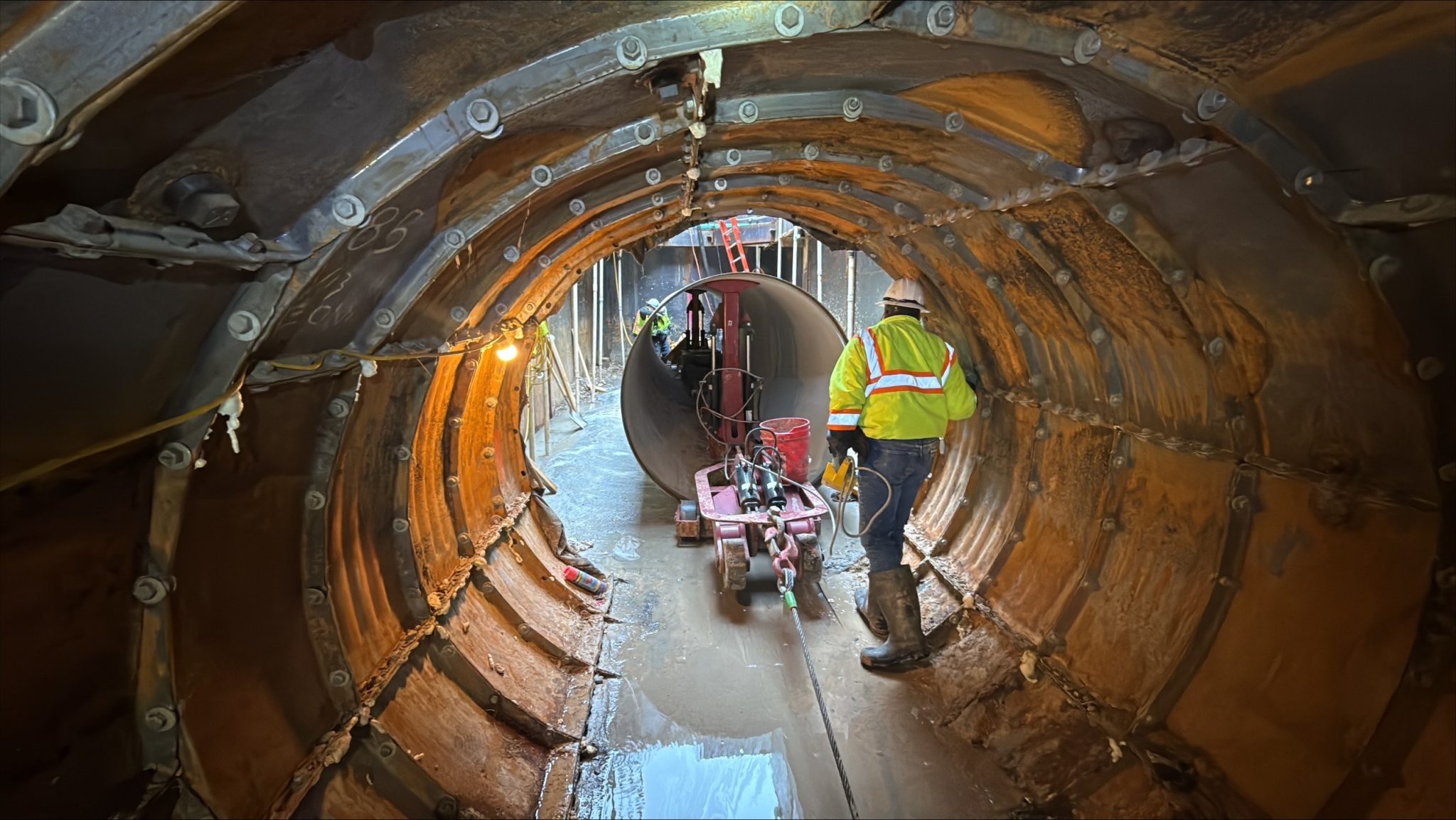

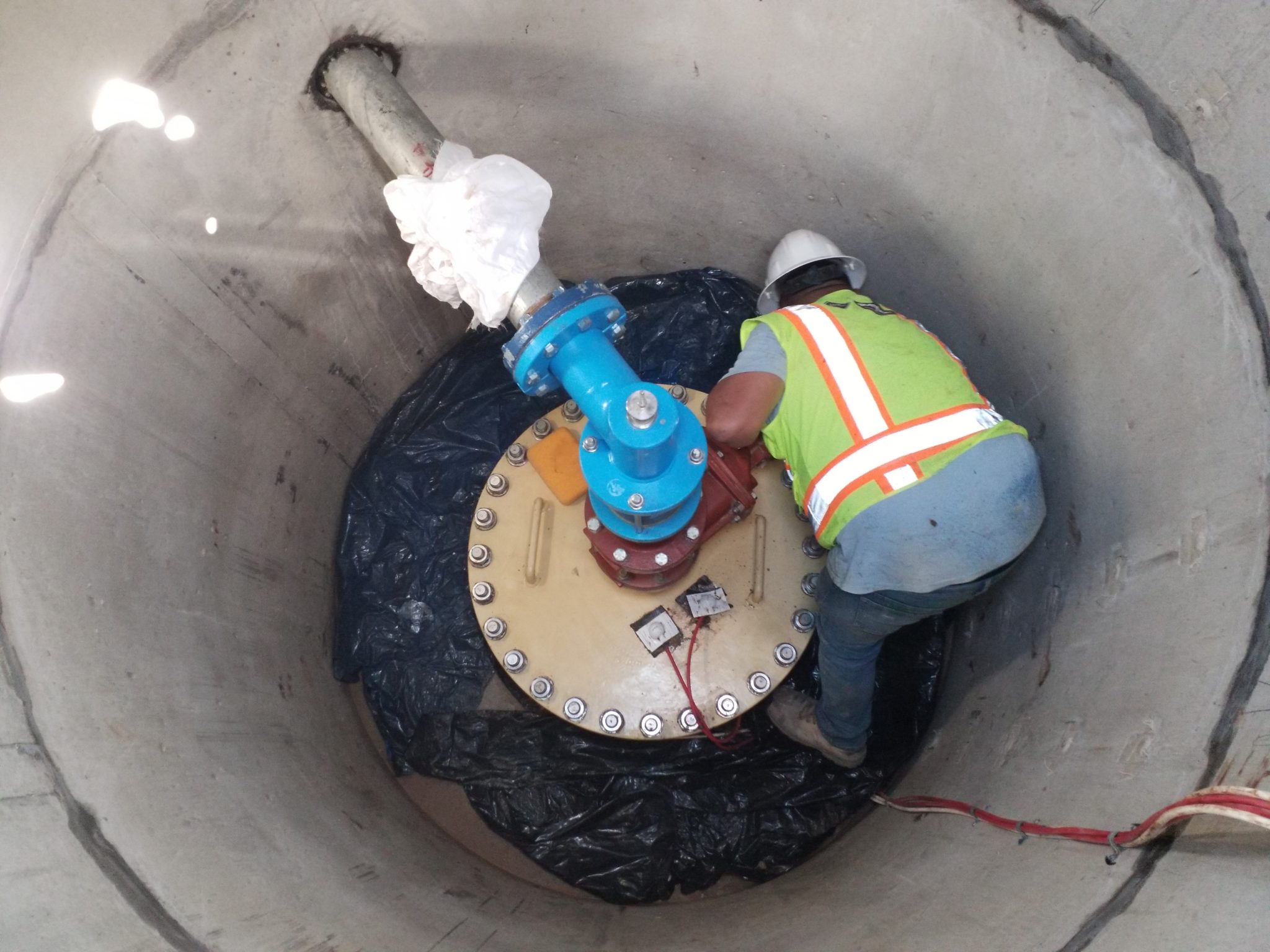

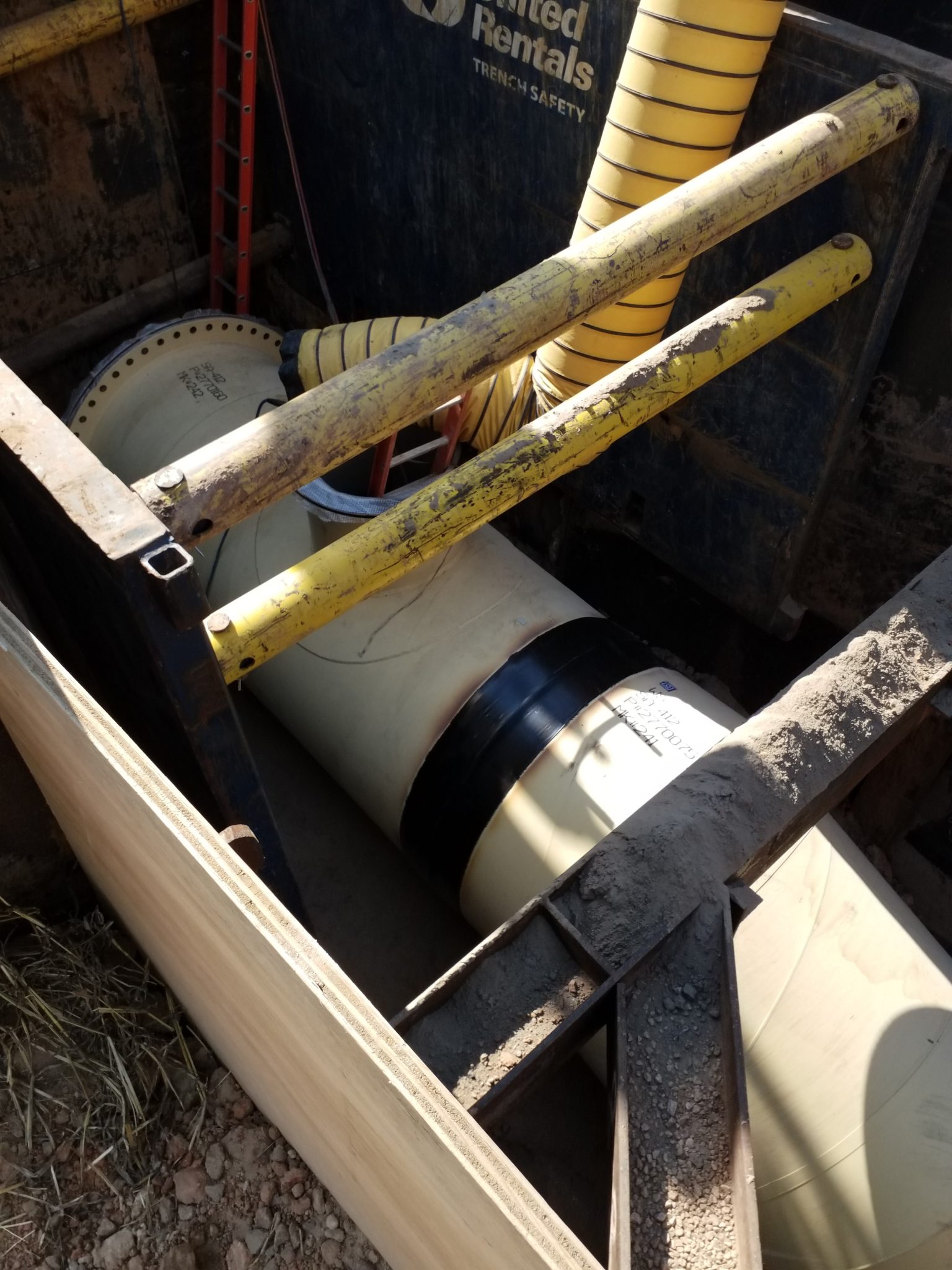

KM4

  • Pipeline Diameter: 66″ to 84″
  • 1.1 miles in length

Anticipated Construction Program Schedule

DESIGN

Ends Summer 2020

BID

Fall 2020

CONSTRUCTION

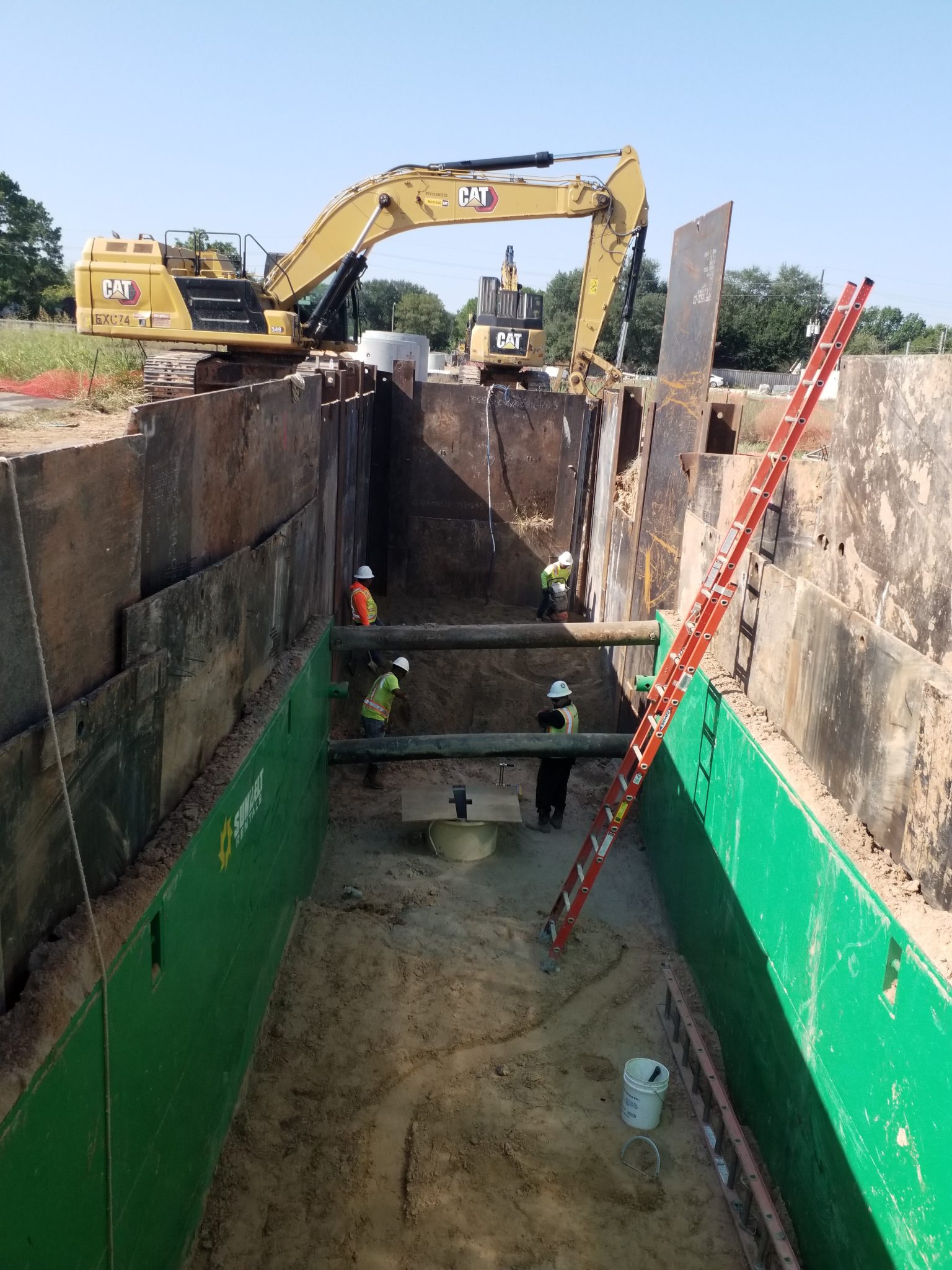

Spring 2021 – Early Summer 2022

Design Consultant: LAN

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM4

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change

SWSP - Kinder Morgan - KM4

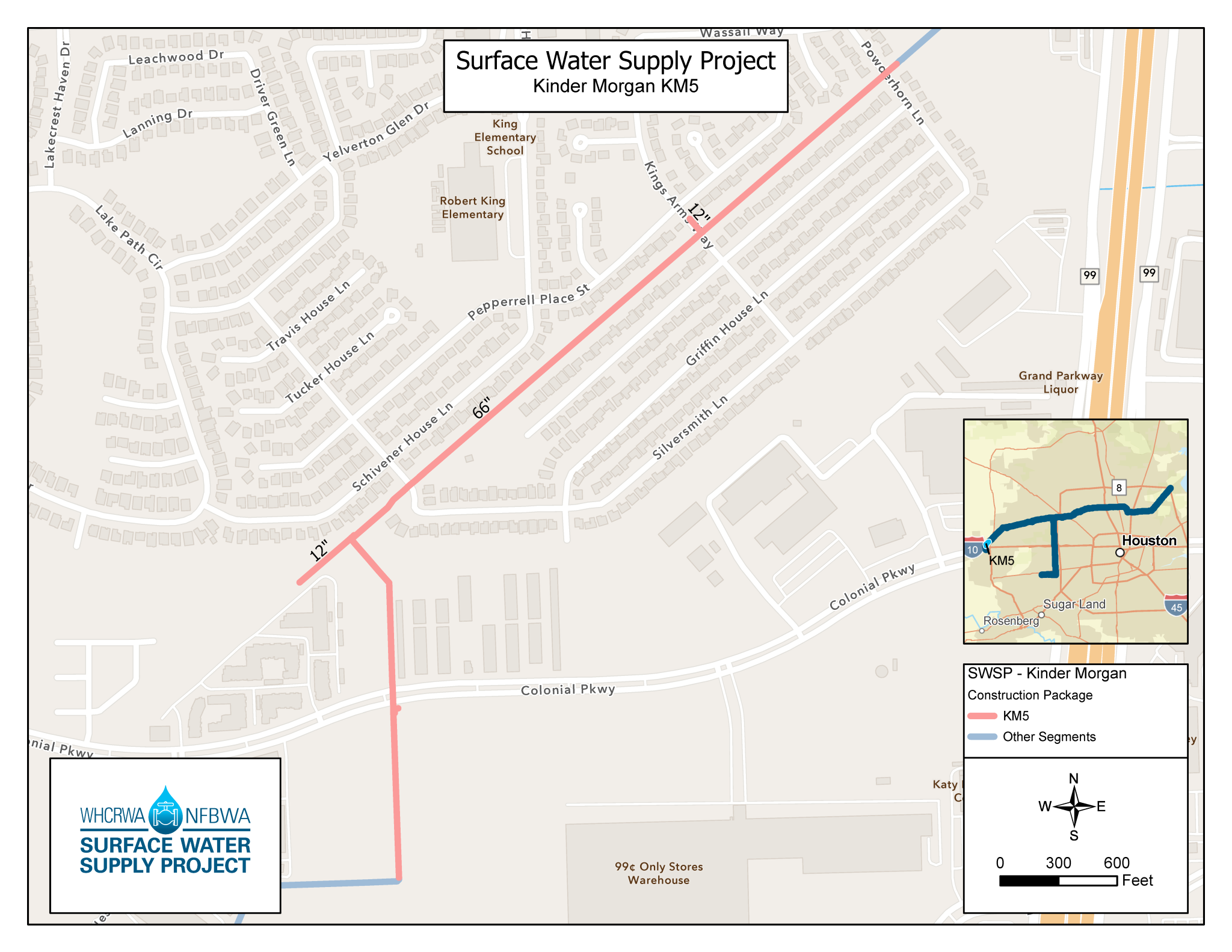

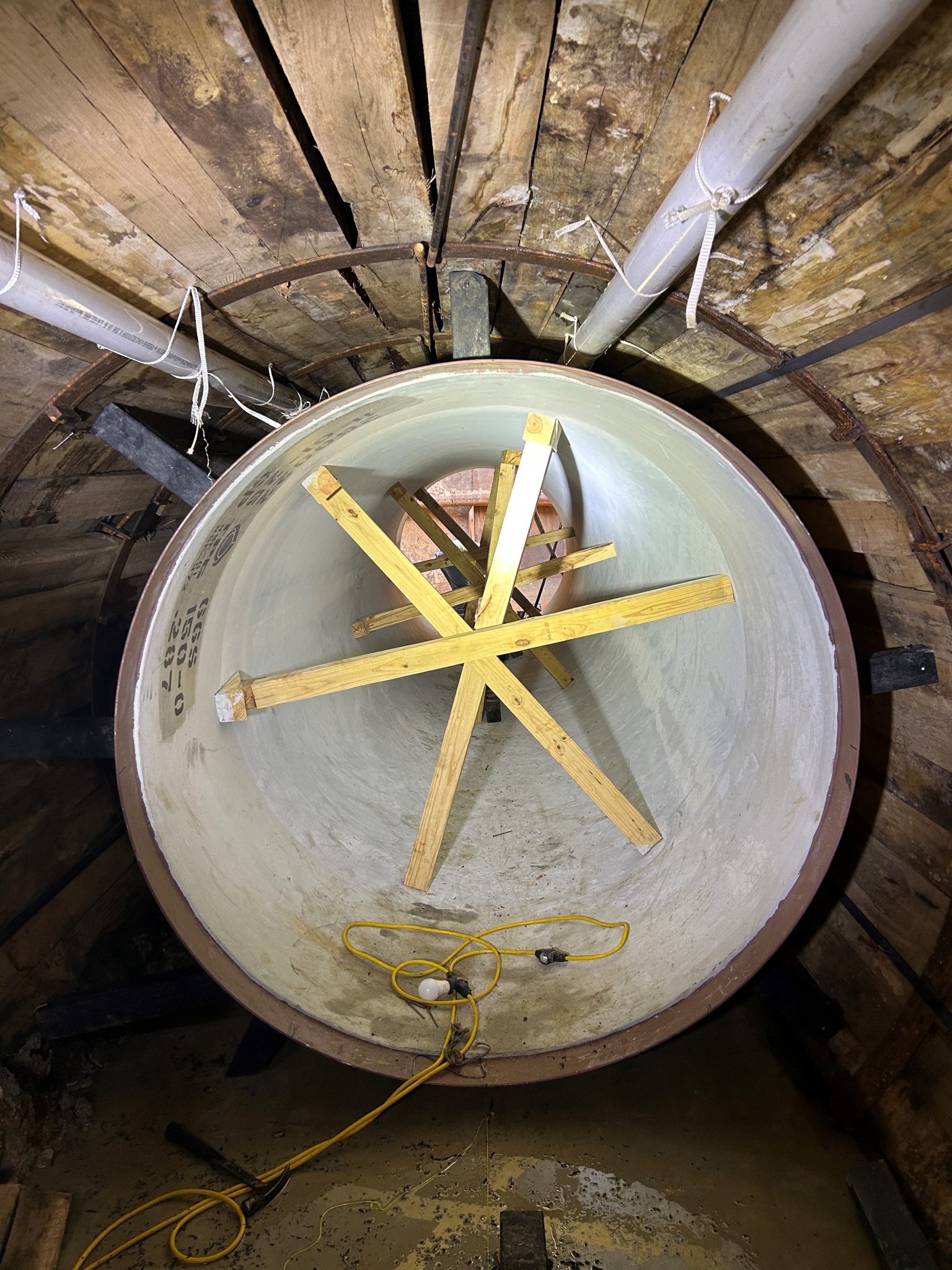

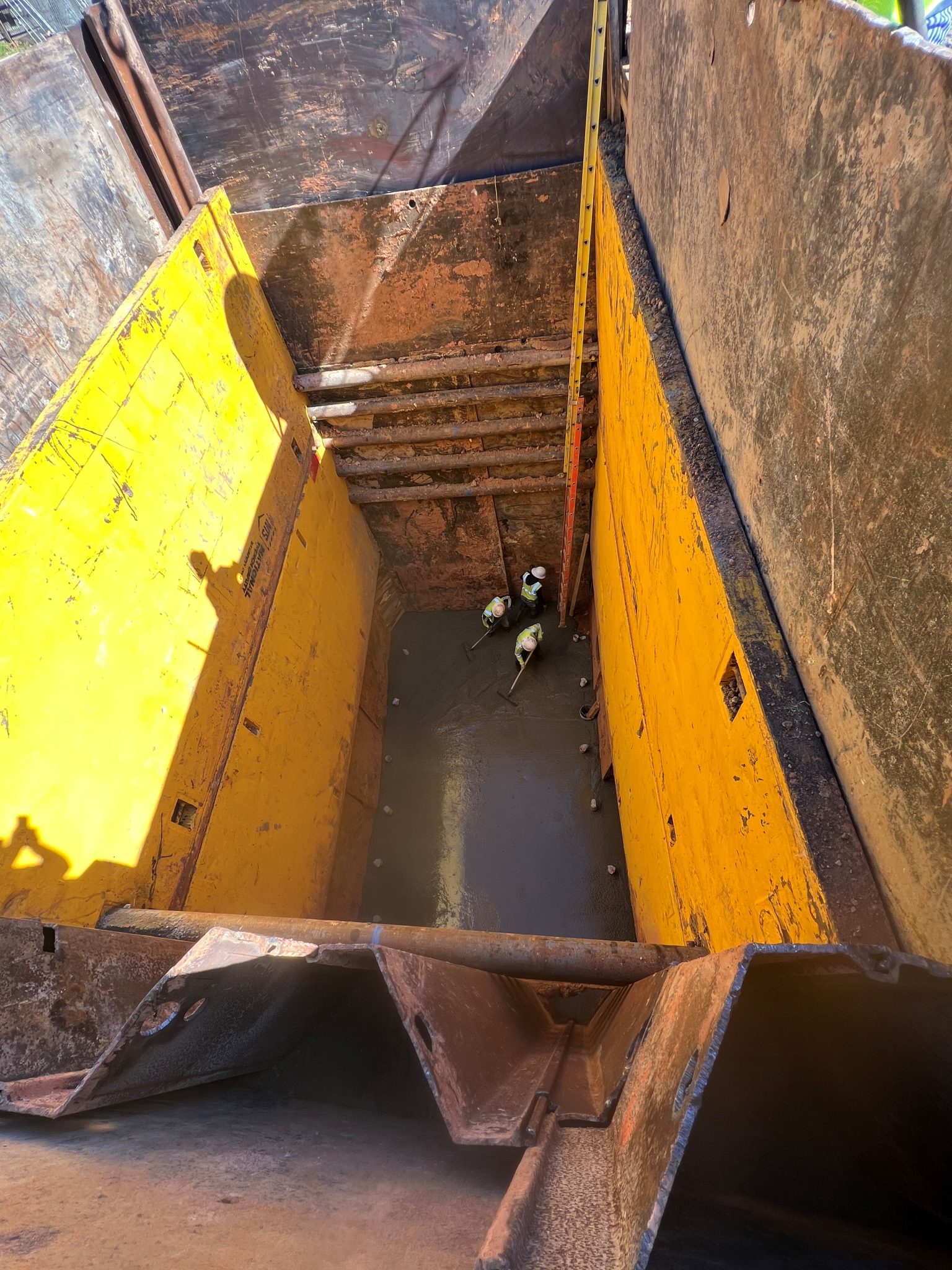

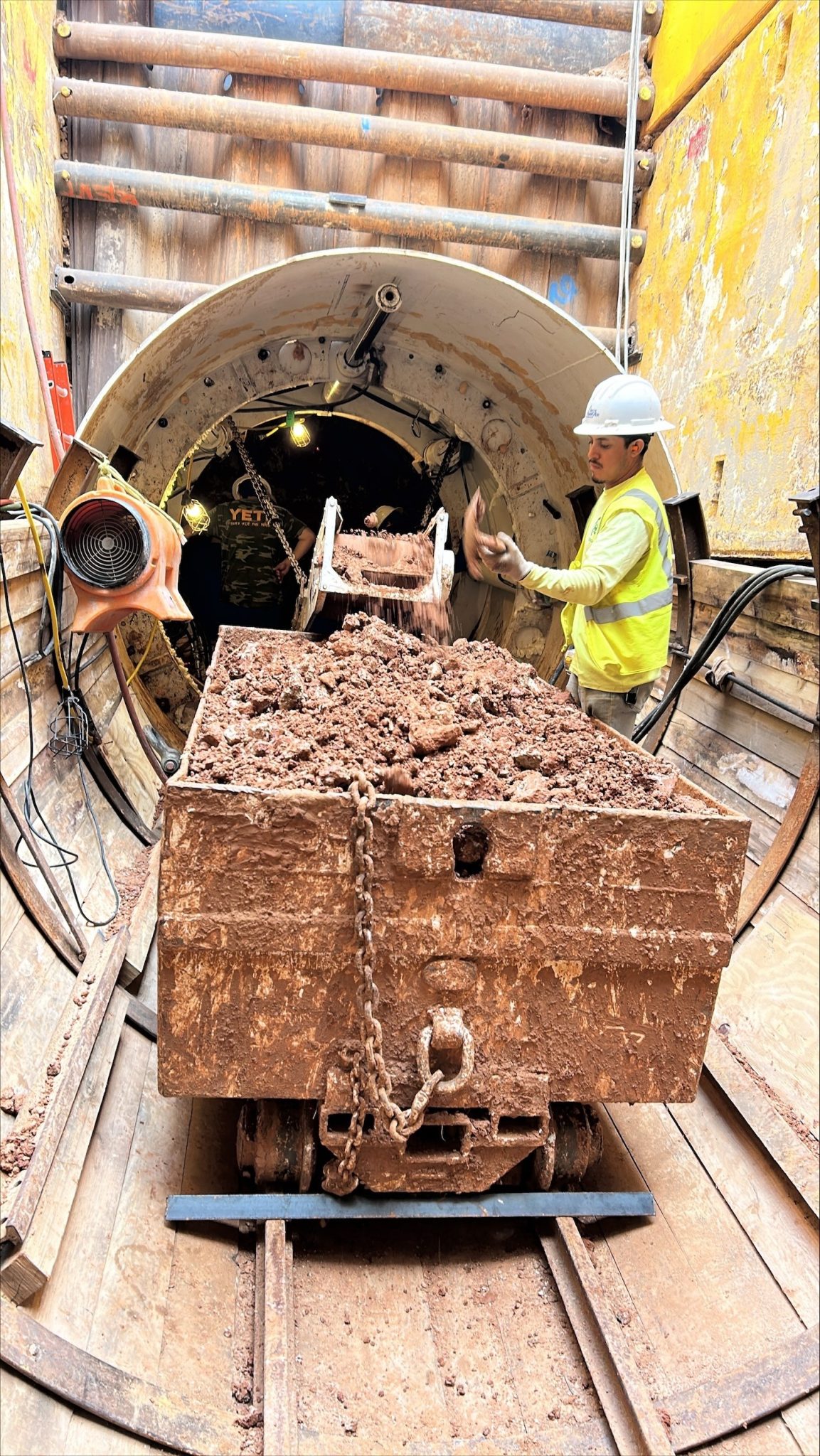

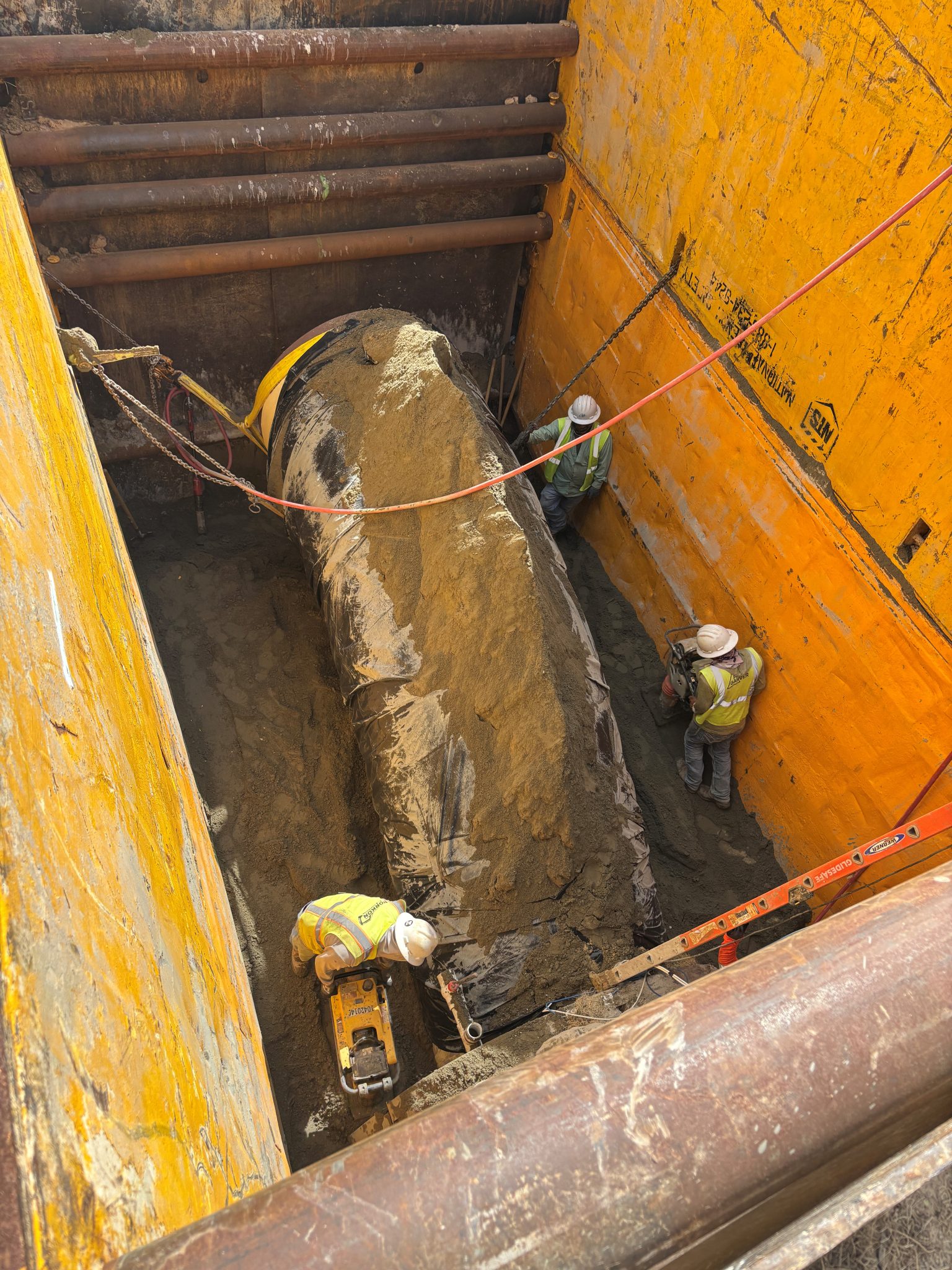

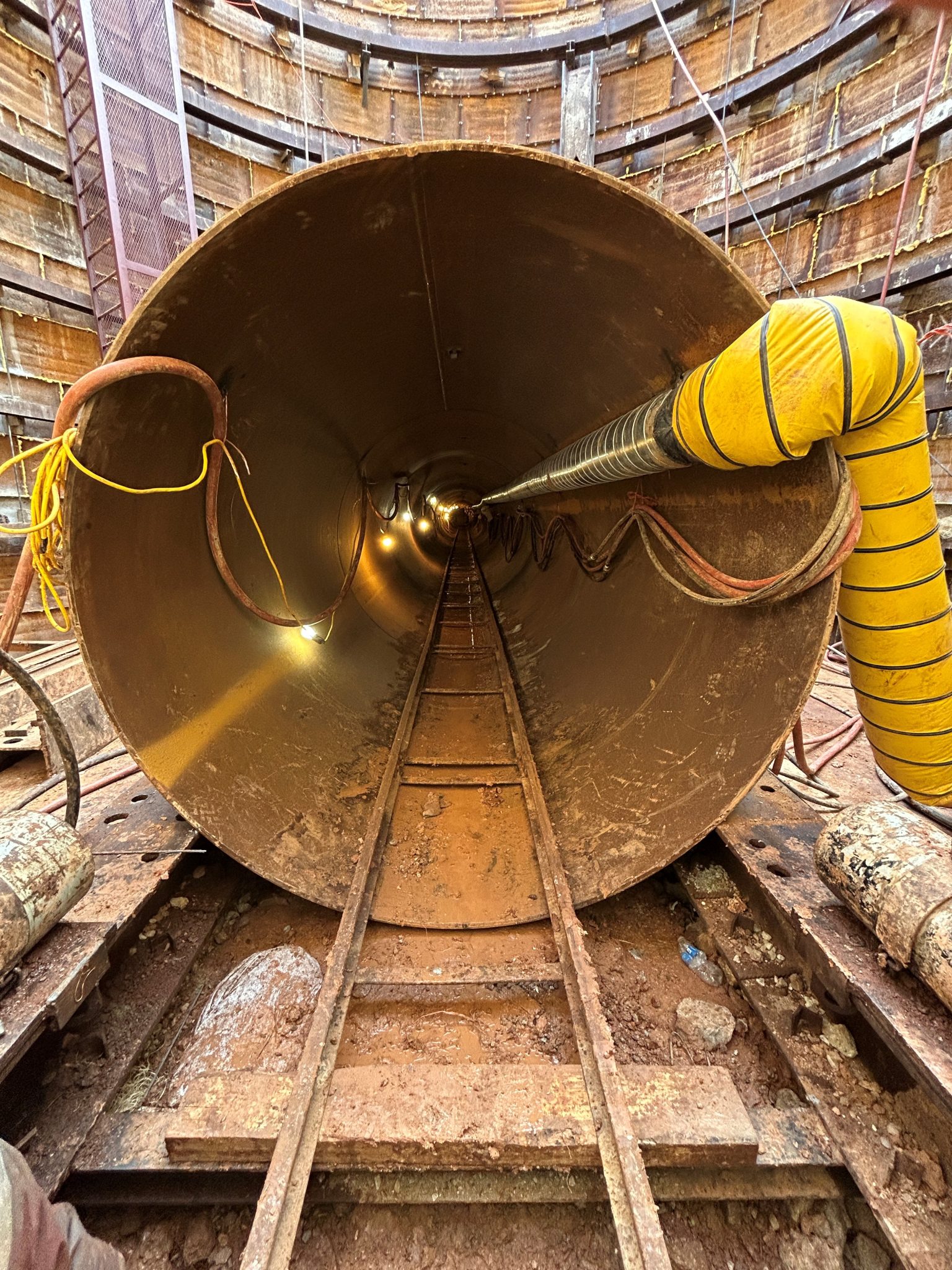

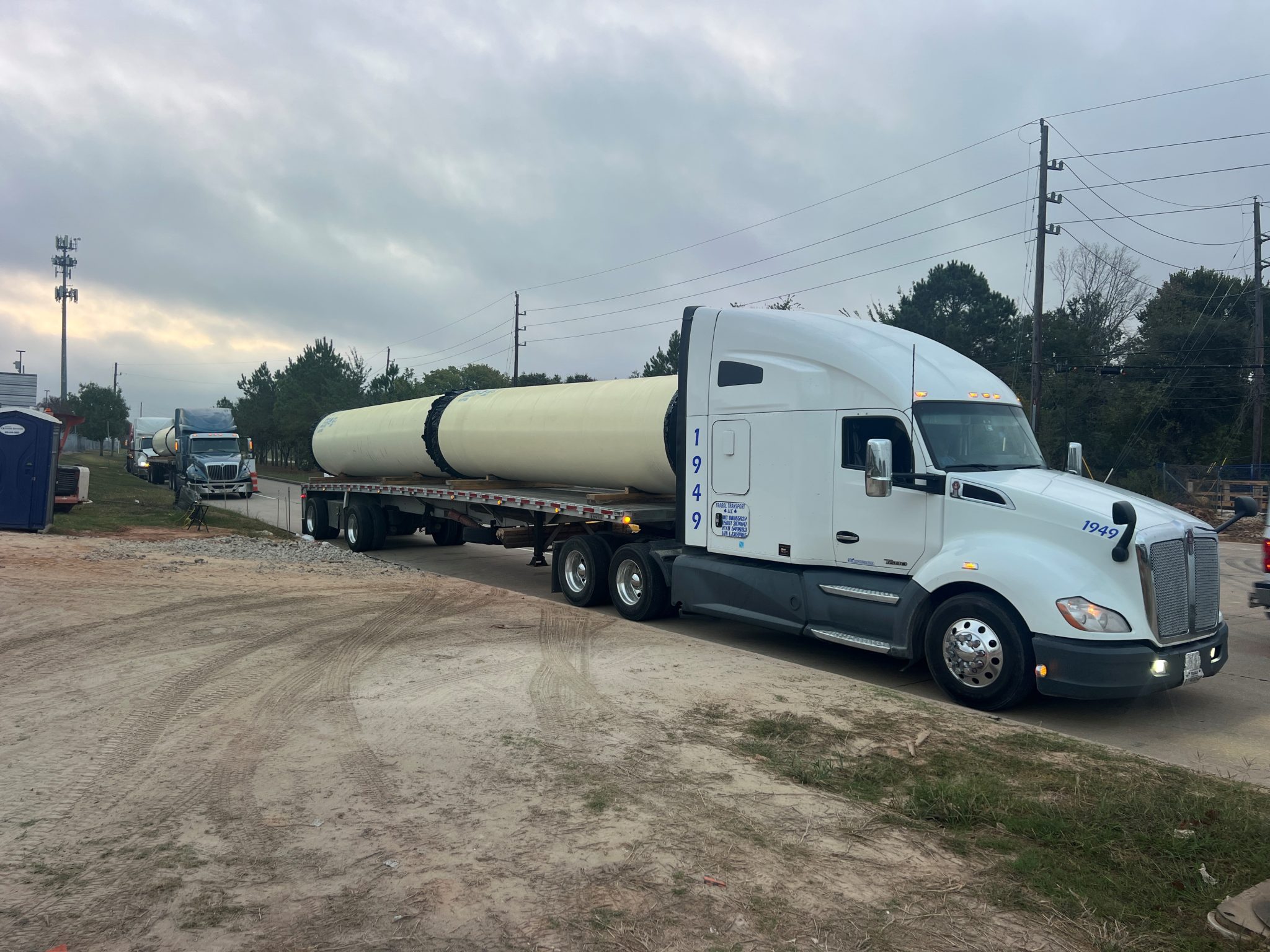

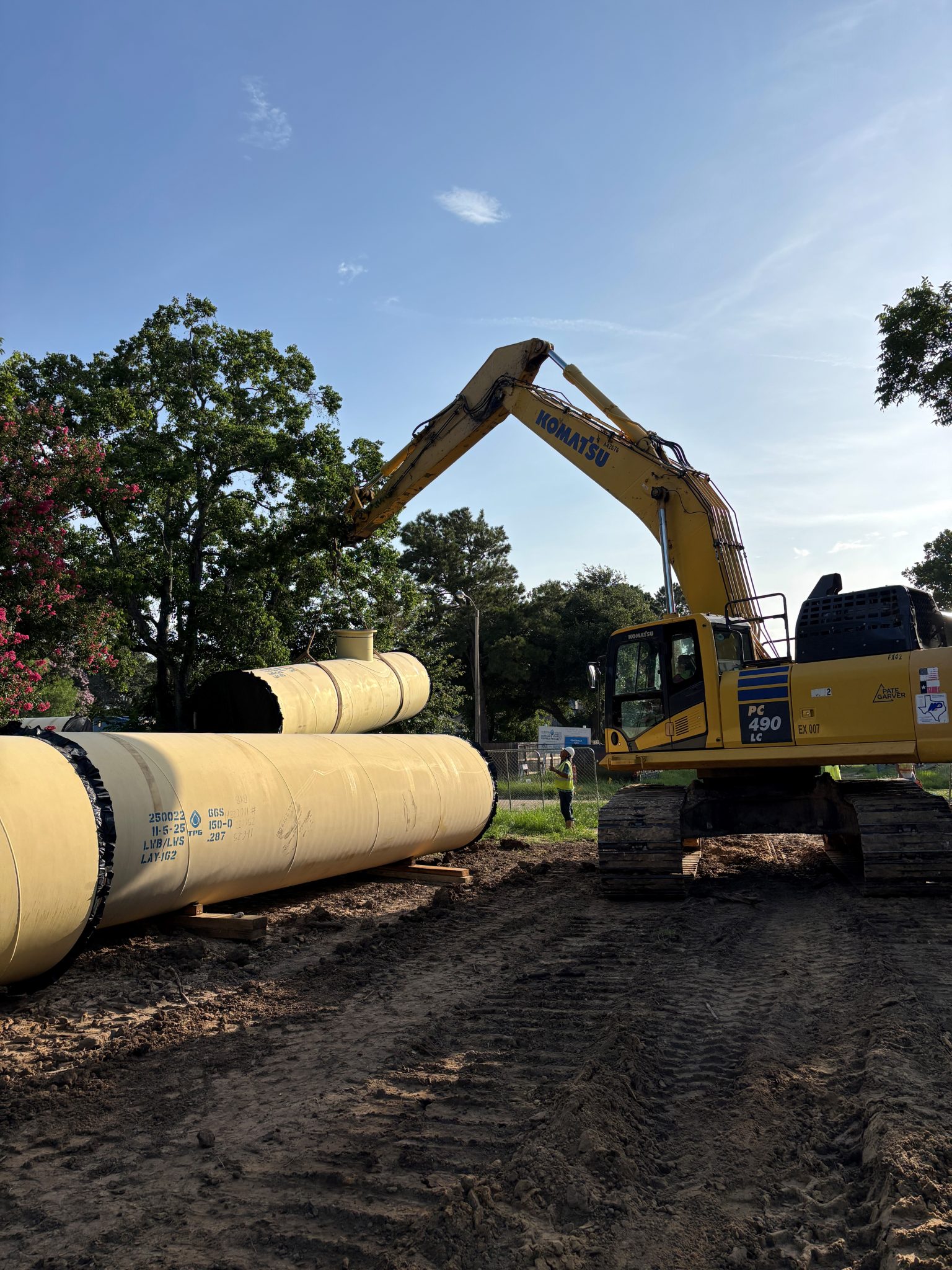

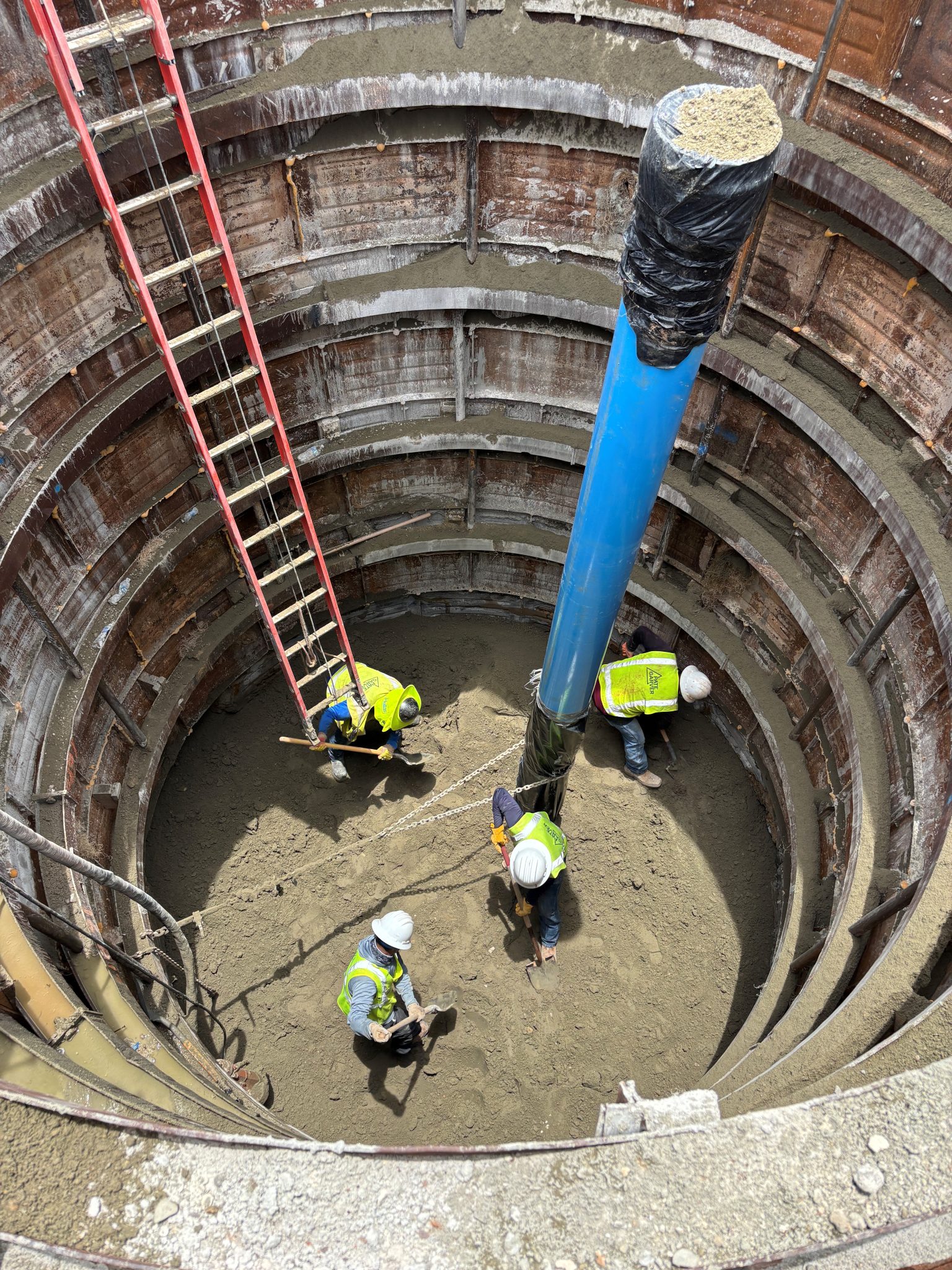

KM5

  • Pipeline Diameter: 66″ to 84″
  • 1 mile in length

Anticipated Construction Program Schedule

DESIGN

Ends Summer 2020

BID

Winter 2020

CONSTRUCTION

Summer 2021 – Early Fall 2022

Design Consultant: Jones & Carter

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM5

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change

SWSP - Kinder Morgan - KM5

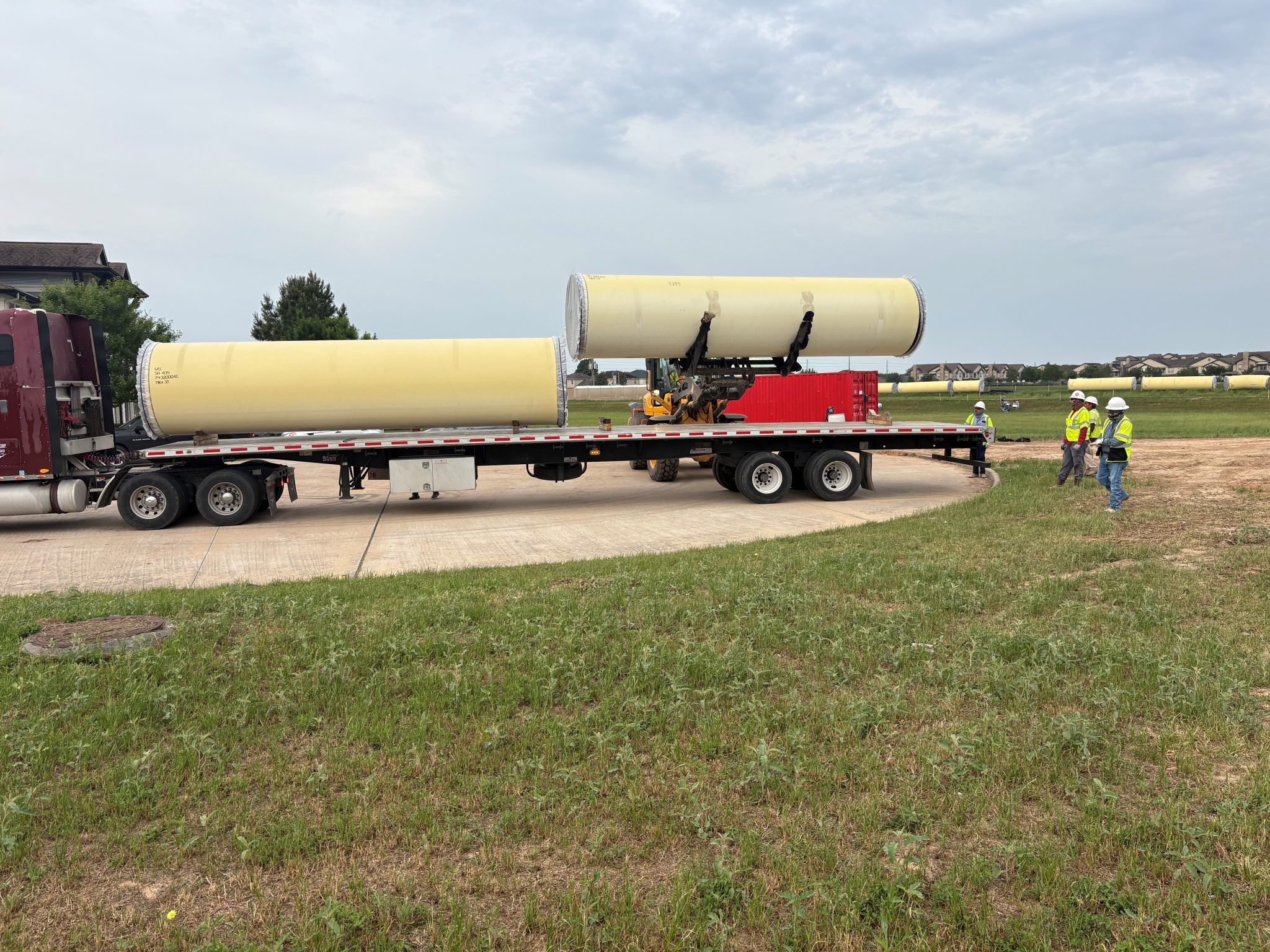

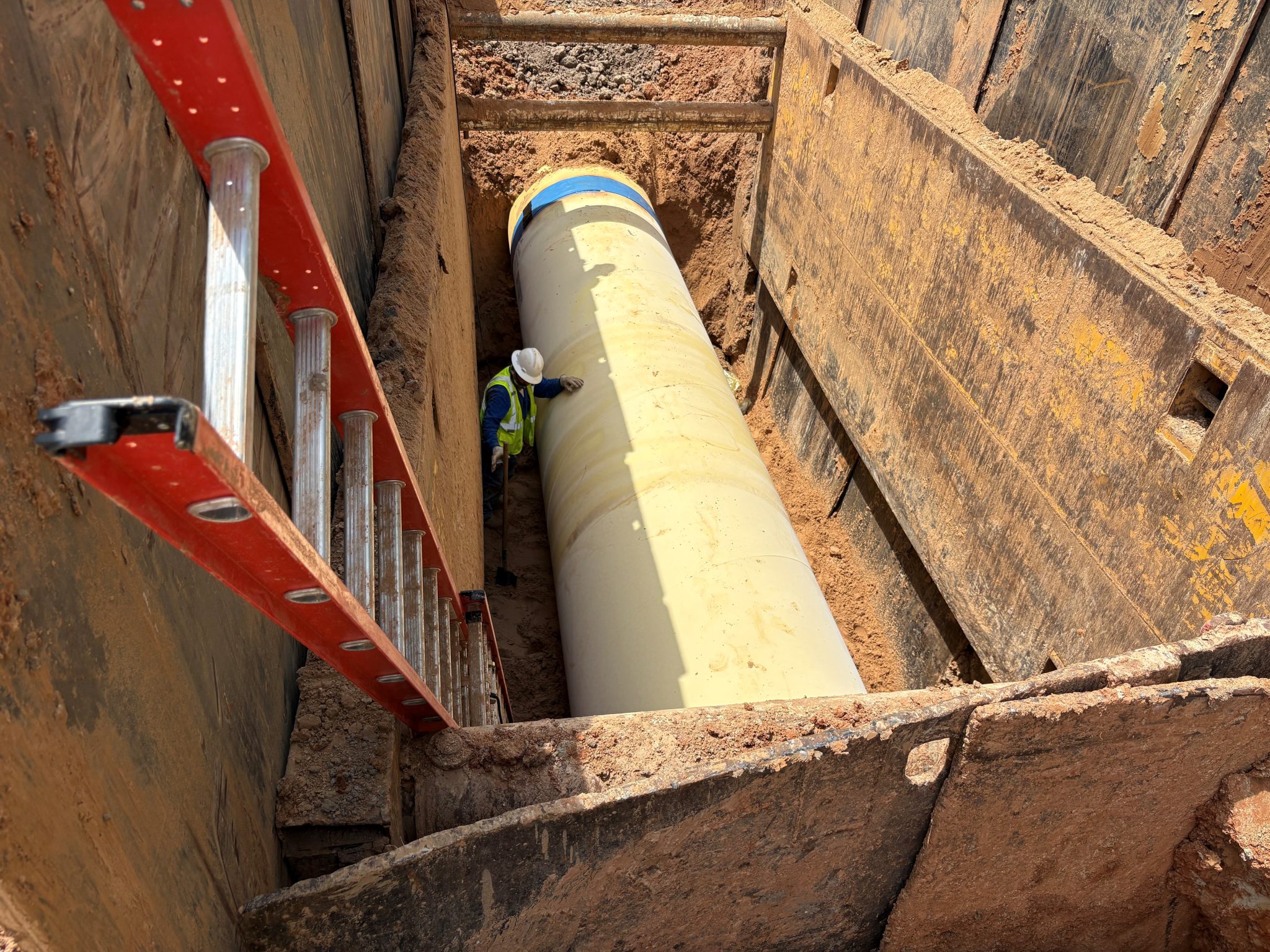

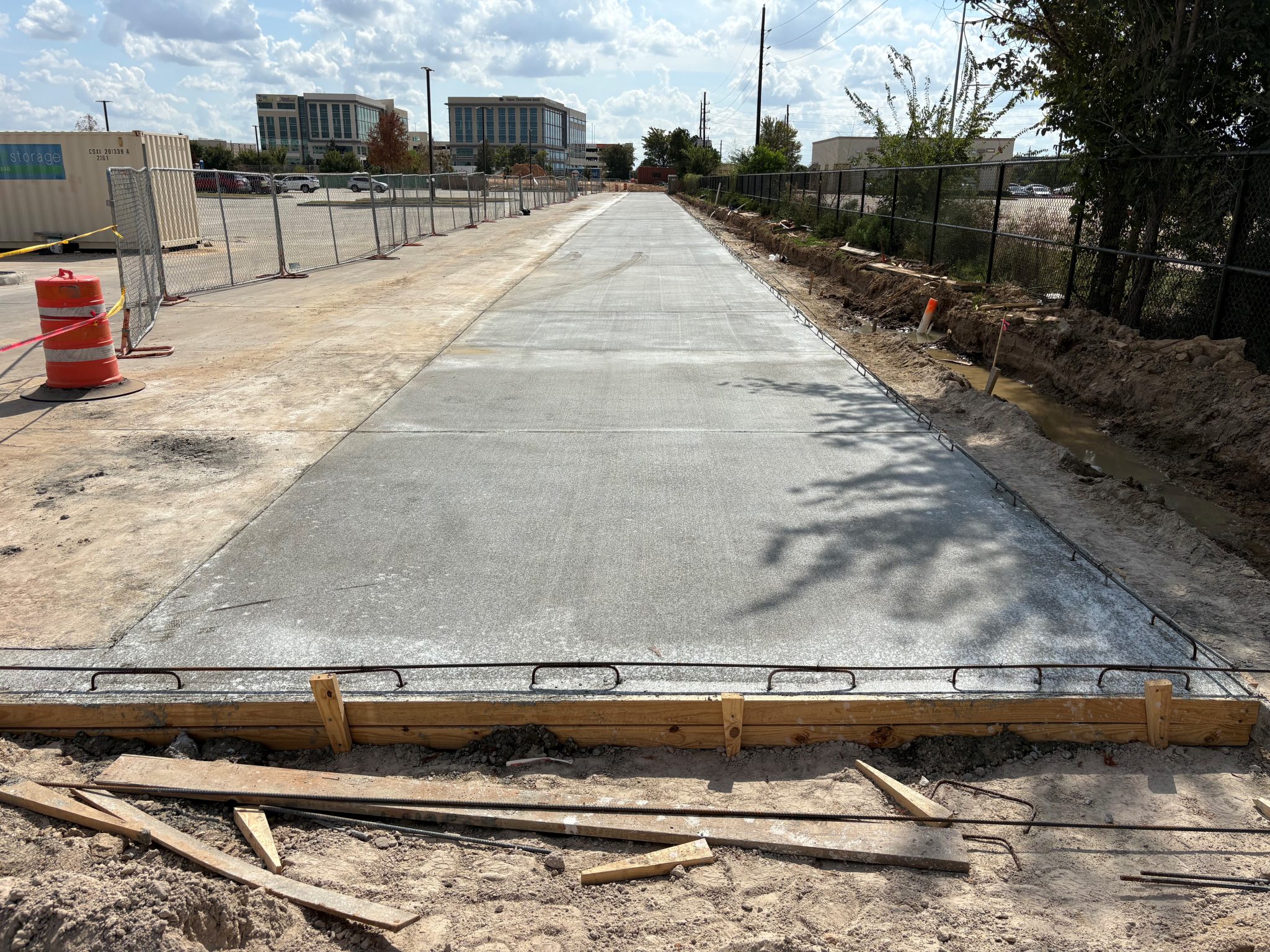

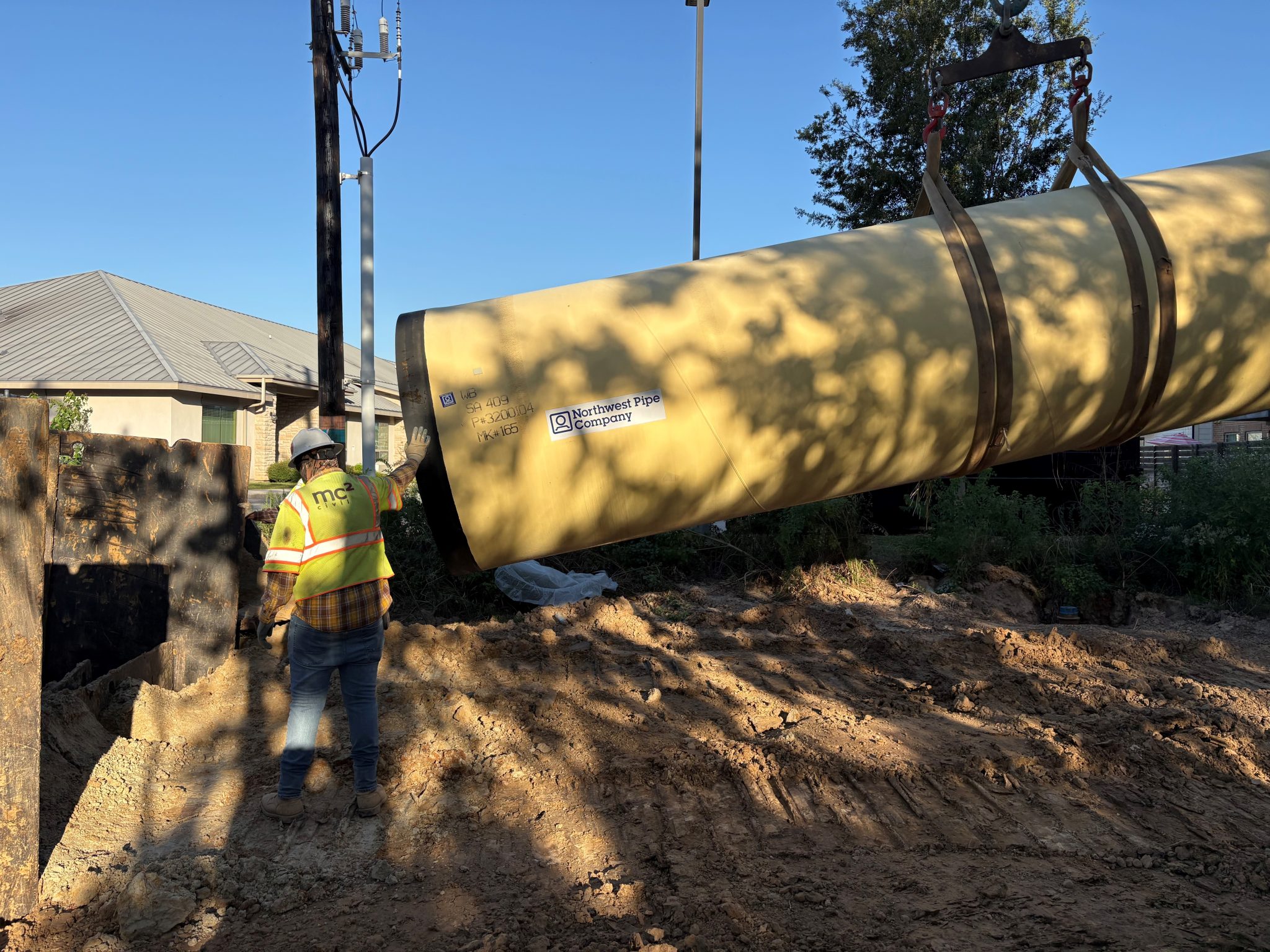

KM6

  • Pipeline Diameter: 66″ to 84″
  • 1 mile in length

Anticipated Construction Program Schedule

DESIGN

Ends Winter 2020

BID

Summer 2021

CONSTRUCTION

Fall 2021 – Late Winter 2022

Design Consultant: Black & Veatch

Contractor: (To be determined)

PDF Map: SWSP – Kinder Morgan – KM6

Contractor Notice to Proceed: (To be determined)

Project Completion: (To be determined)

Dates are subject to change
