Segment 3 (CenterPoint Corridor)

Approximately 13.8 miles of 42-inch-diameter pipeline.

The Segment 3 waterline is a 42-inch waterline that extends approximately 13.8 miles from Segment C (84-inch Waterline) near Brittmoore Road to the NFBWA Bellaire Pump Station along CenterPoint Energy (CPE) easements and some private easements.

Segment 3 will provide water to both NFBWA and WHCRWA customers via the Bellaire Pump Station.

Segment 3 is currently planned to be constructed in six separate construction packages. Per the agreement with CPE, waterline construction within the CPE corridor has to start construction by February 27, 2020.

Although the agreement does not specify the duration to construct the waterline through the entire corridor, construction activities are anticipated to finalize by the first quarter of 2023 The construction projects will be advertised in the Houston Business Journal and available on Civcast online bidding website. These projects will not require pre-qualification and consequently will be open to any contractor.

SEG3-A1

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ends Q2/2020

BID

Q2/2021

CONSTRUCTION

Q2/2021 – Q3/2022

Design Consultant: Binkley & Barfield, Inc. (BBI)

Contractor: (To be posted)

PDF Map: SWSP – Segment 3 A-1

Contractor Notice to Proceed: (To be posted)

Project Completion: (To be posted)

Dates are subject to change

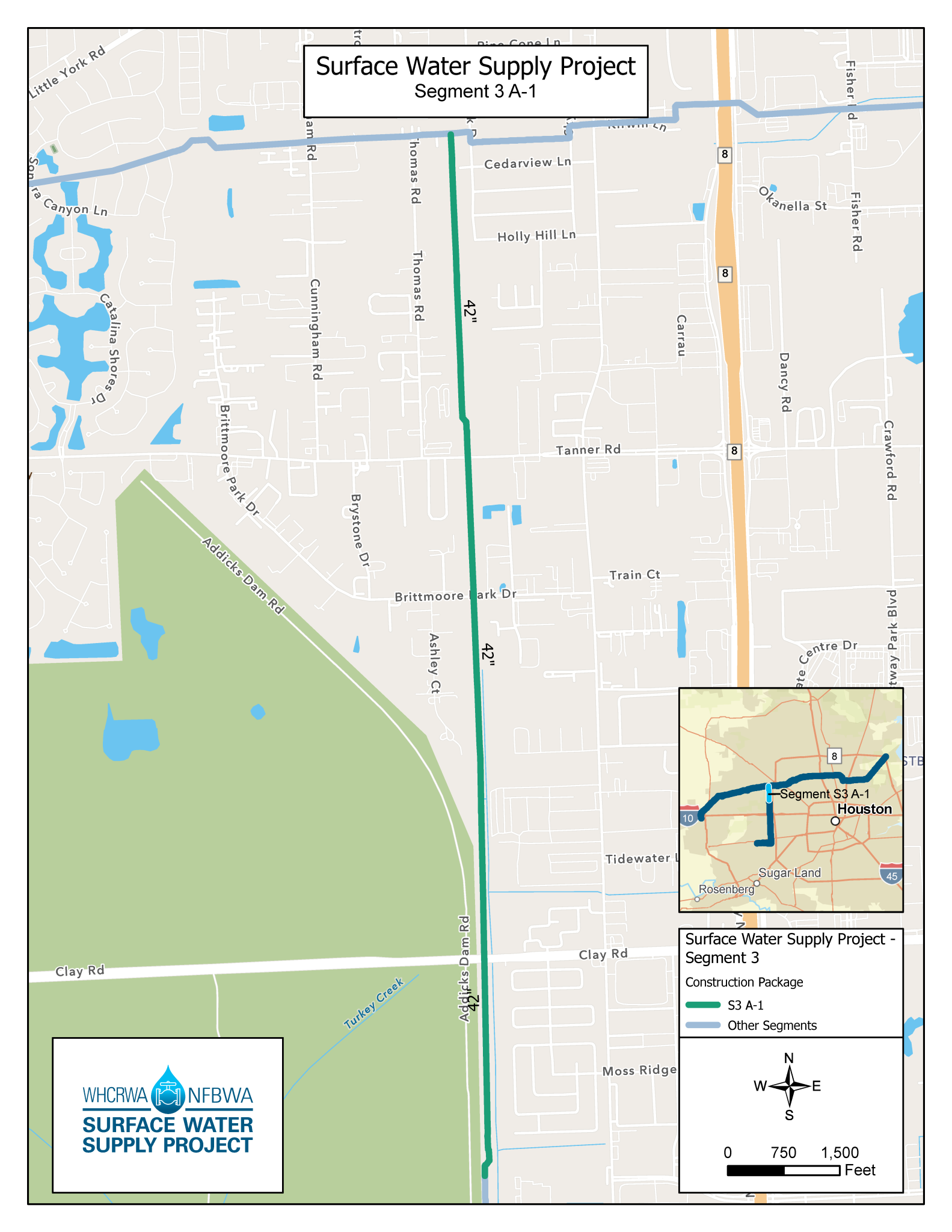

SWSP - Segment 3 A-1

SEG3-A2

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ends Q2/2020

BID

Q2/2021

CONSTRUCTION

Q2/2021 – Q1/2023

Design Consultant: Kimley-Horn

Contractor: (To be posted)

PDF Map: SWSP – Segment 3 A-2

Contractor Notice to Proceed: (To be posted)

Project Completion: (To be posted)

Dates are subject to change

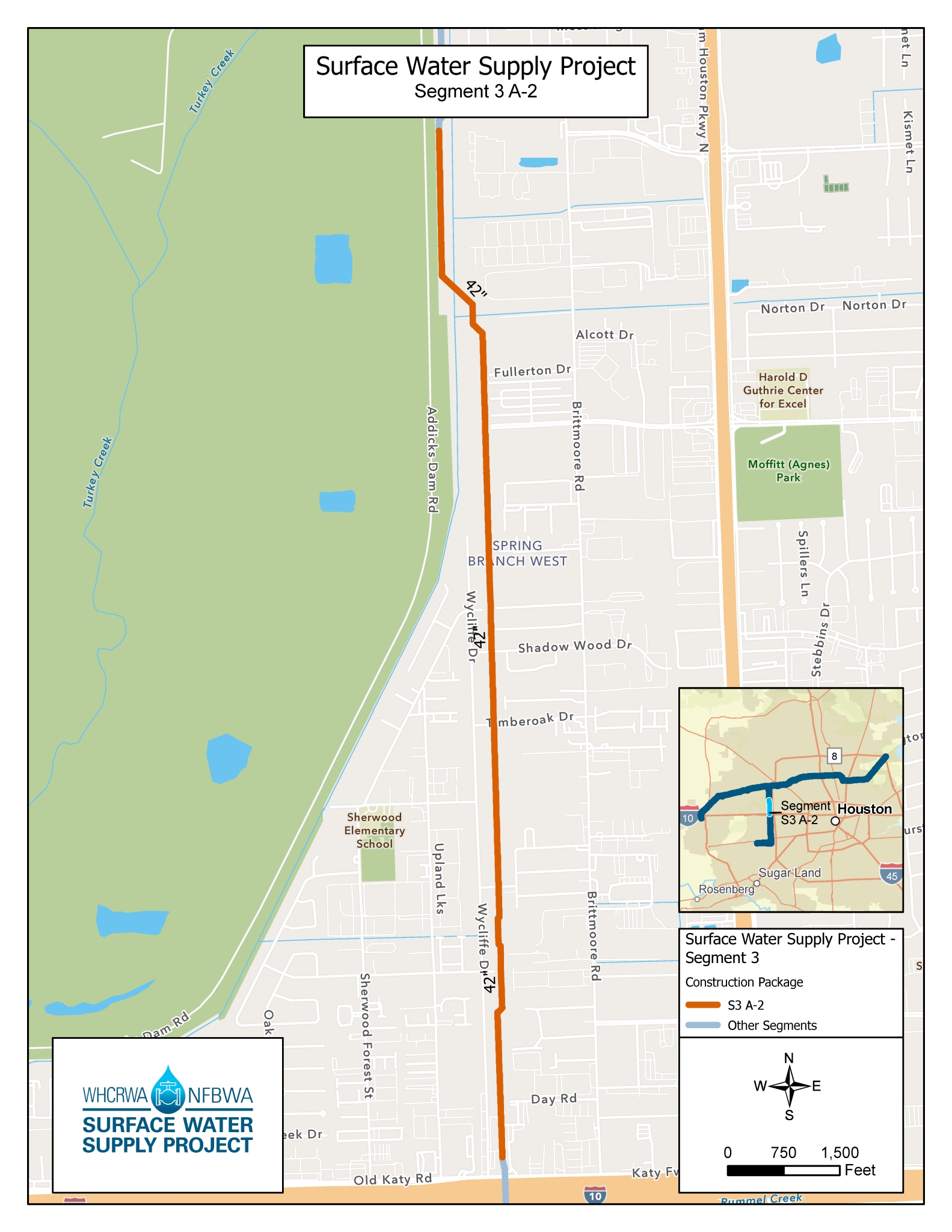

SWSP - Segment 3 A-2

SEG3-A3

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ends Q1/2020

BID

Q3/2020

CONSTRUCTION

Q1/2021 – Q2/2022

Design Consultant: Freese and Nichols, Inc. (FNI)

Contractor: (To be posted)

PDF Map: SWSP – Segment 3 A-3

Contractor Notice to Proceed: (To be posted)

Project Completion: (To be posted)

Dates are subject to change

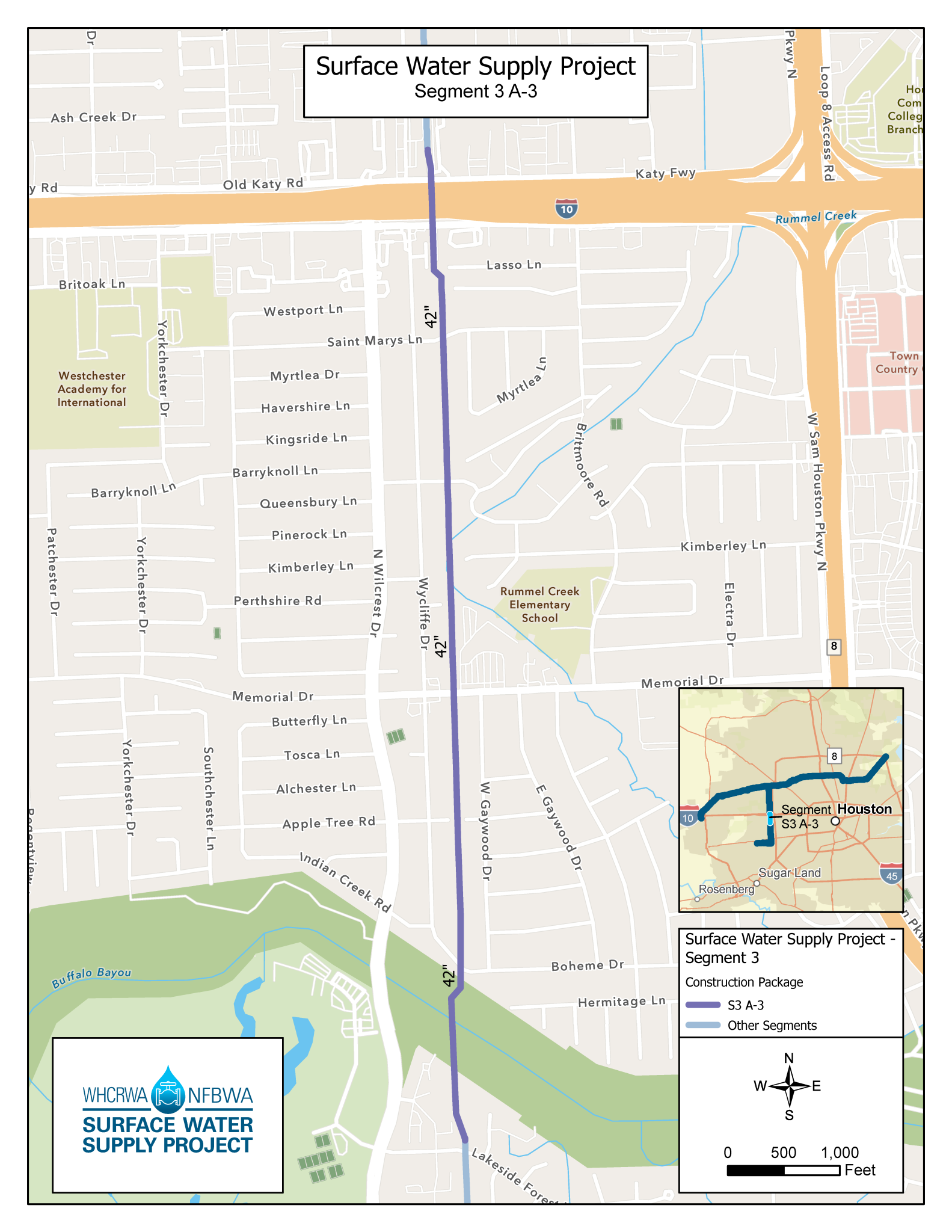

SWSP - Segment 3 A-3

SEG3-A4

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ended Q3/2019

BID

Q4/2019

CONSTRUCTION

Q1/2020 – Q4/2020

Design Consultant: Costello

Contractor: Garney Construction

PDF Map: SWSP – Segment 3 A-4

Contractor Notice to Proceed: 12/11/2019

Project Completion: Q4/2020

Dates are subject to change

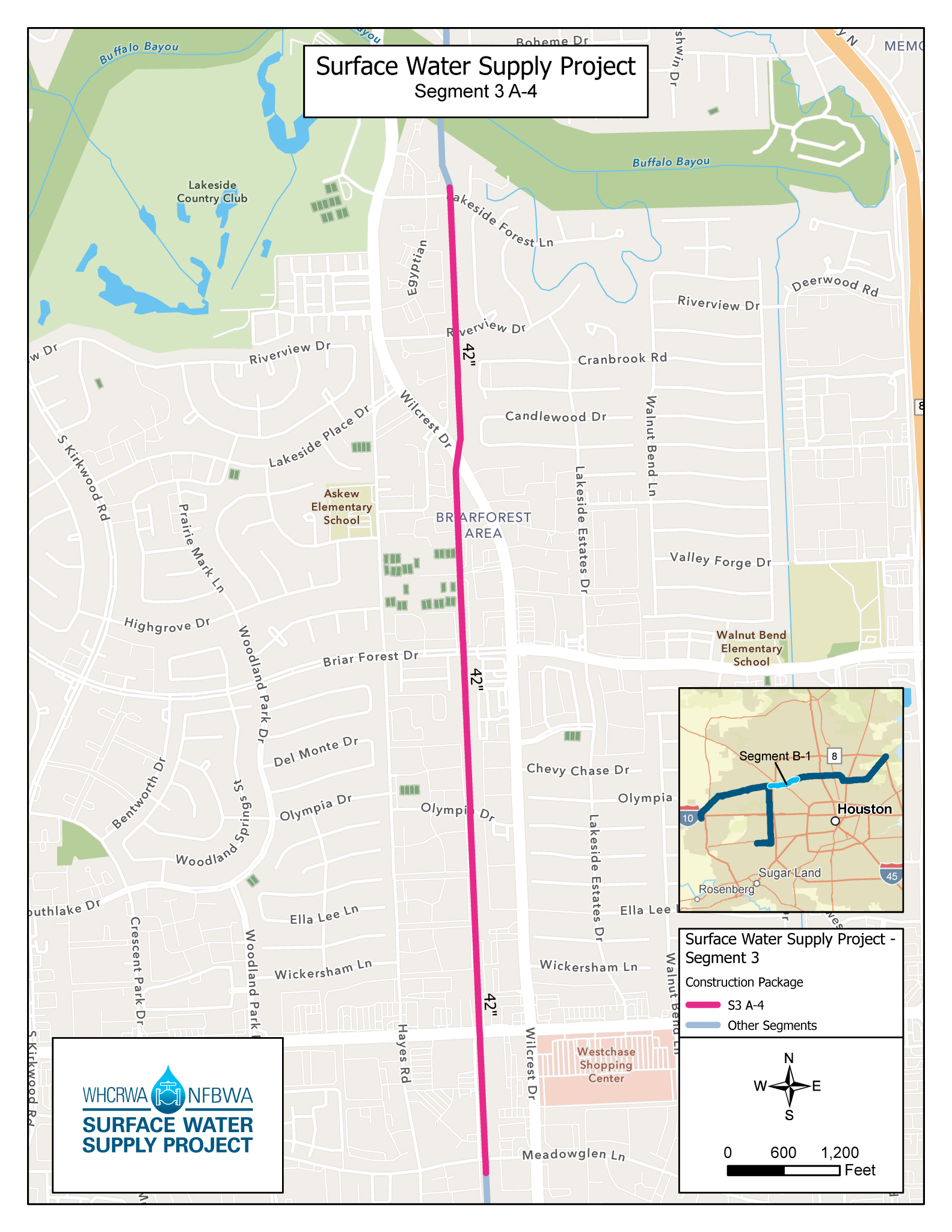

SWSP - Segment 3 A-4

SEG3-A5

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ends Q2/2020

BID

Q1/2021

CONSTRUCTION

Q2/2021– Q2/2022

Design Consultant: Huitt-Zollars,Inc.

Contractor: (To be posted)

PDF Map: SWSP – Segment 3 A-5

Contractor Notice to Proceed: (To be posted)

Project Completion: (To be posted)

Dates are subject to change

SWSP - Segment 3 A-5

SEG3-B1

  • Pipeline Diameter: 42″

Anticipated Construction Program Schedule

DESIGN

Ends Q3/2020

BID

Q1/2021

CONSTRUCTION

Q2/2021– Q1/2023

Design Consultant: BGE, Inc. (BGE)

Contractor: (To be posted)

PDF Map: SWSP – Segment 3 B-1

Contractor Notice to Proceed: (To be posted)

Project Completion: (To be posted)

Dates are subject to change

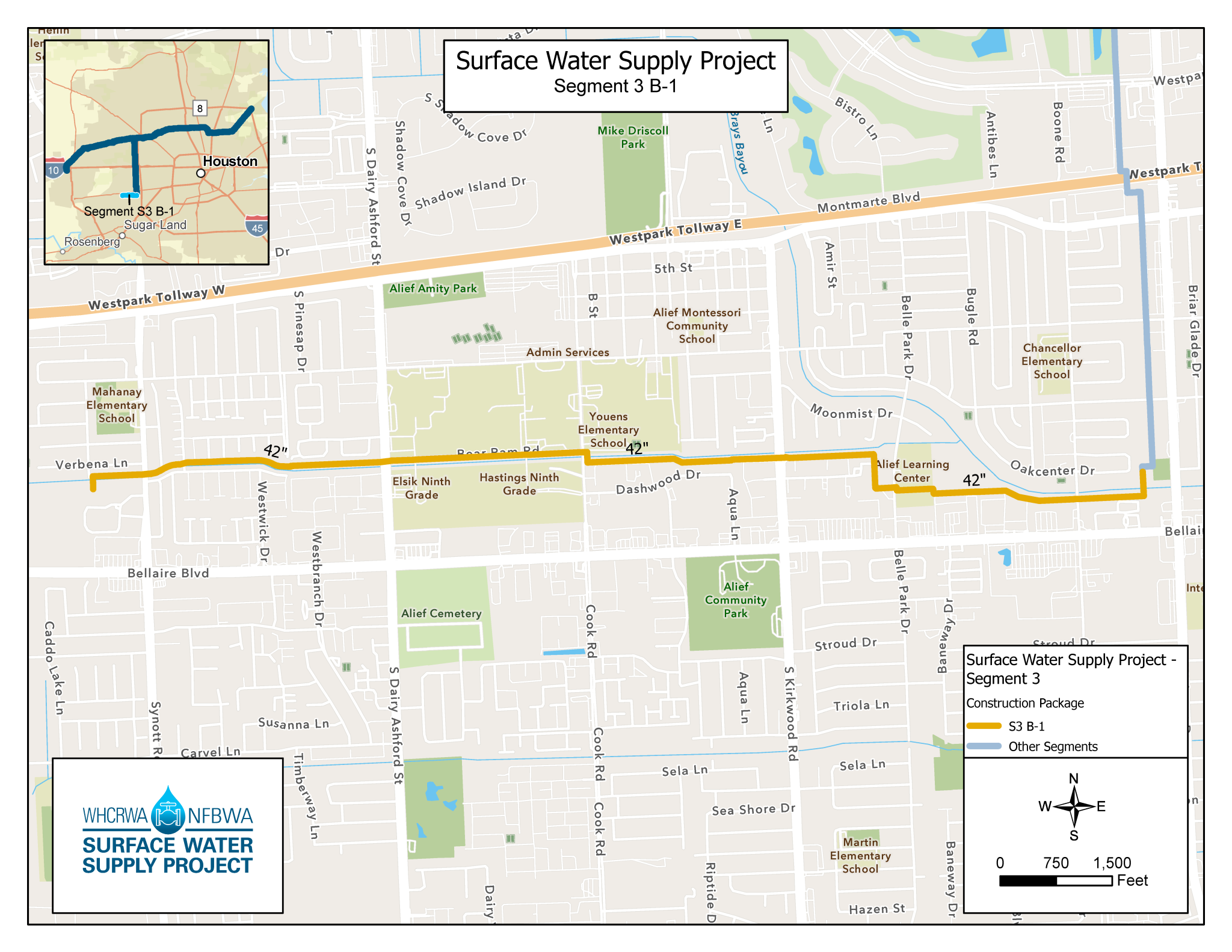

SWSP - Segment 3 B-1
